Project Management (Remediation)

Enterprise Feature

Project Management is available exclusively in OpenGRC Enterprise. Learn more about Enterprise.

OpenGRC Project Management provides a structured way to track and remediate findings from audits, risk assessments, and compliance reviews. Create projects to organize corrective actions, assign tasks to team members, and monitor progress through Kanban boards or list views.

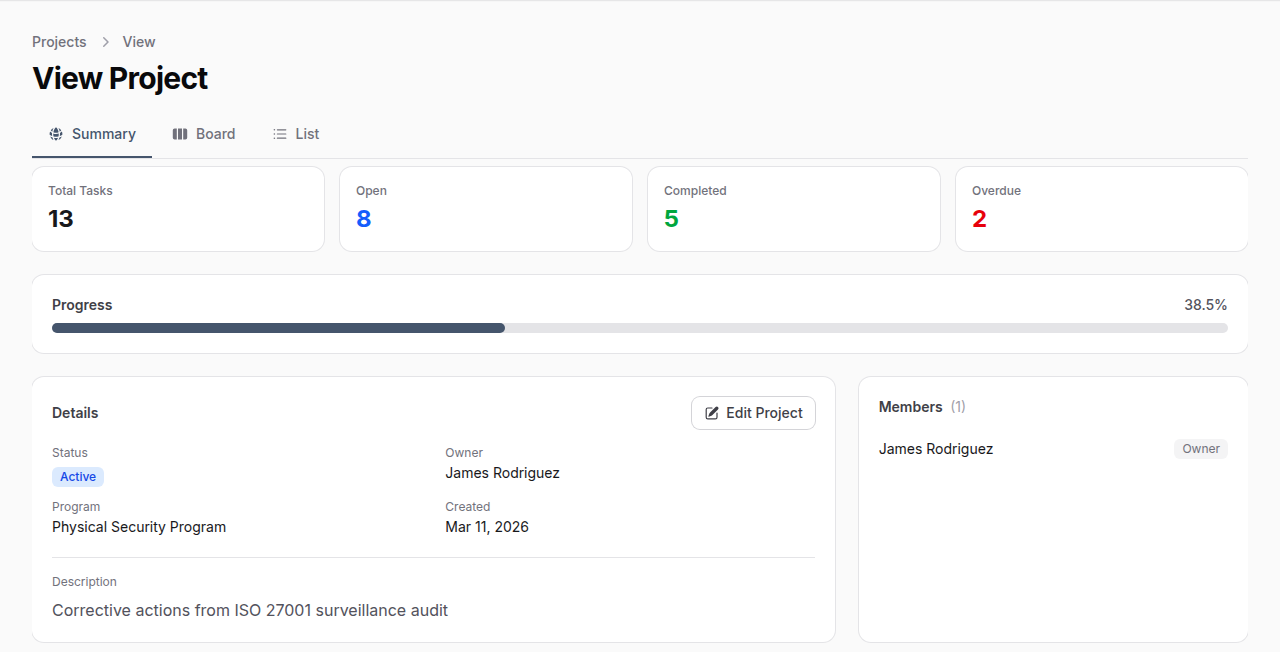

Project Summary

Overview

Project Management helps organizations:

  • Organize remediation efforts into trackable projects (POA&Ms)
  • Create tasks directly from audit findings for full traceability
  • Assign owners and due dates to ensure accountability
  • Visualize work with Kanban boards or task lists
  • Track progress with real-time statistics and completion percentages
  • Manage team membership and roles per project

Projects

Project List

The project list shows all projects visible to you, including projects you own or are a member of.

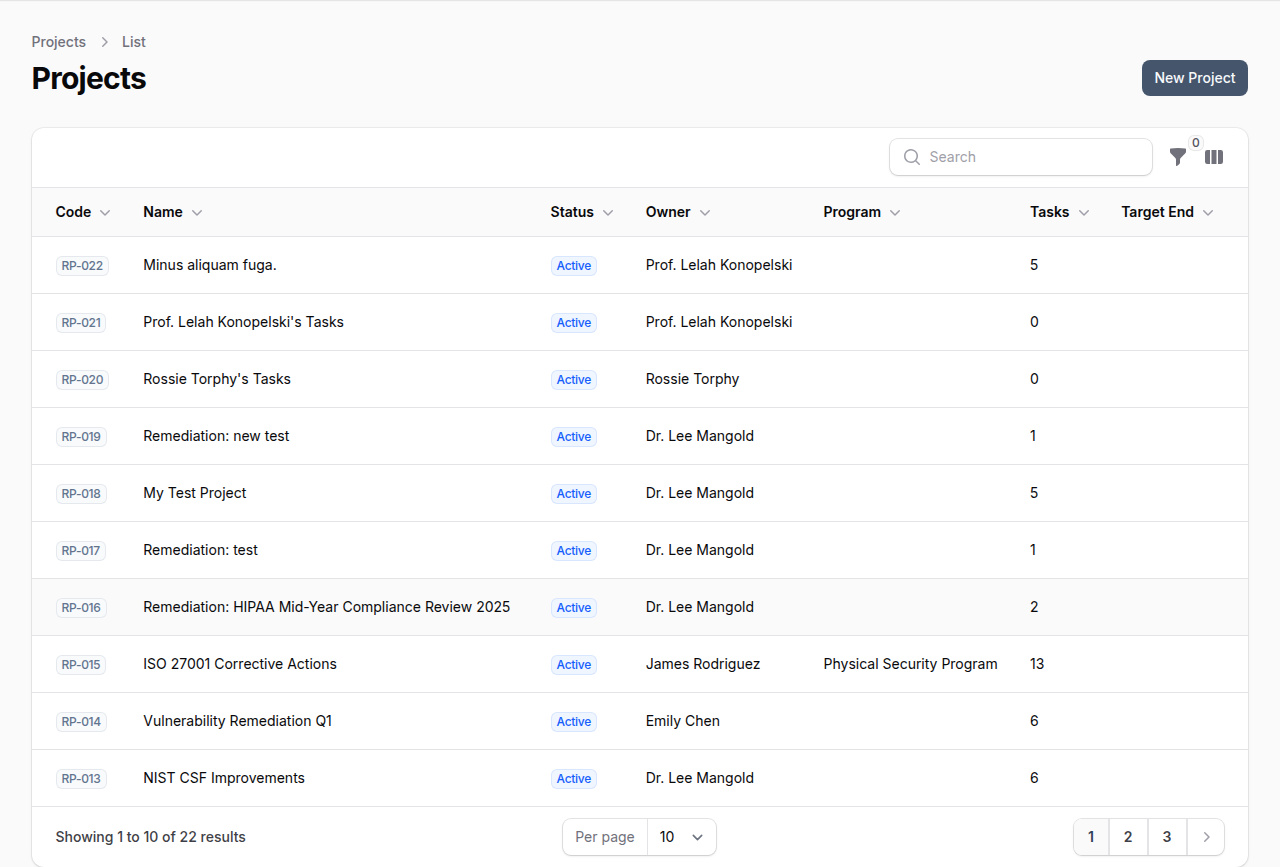

Project List

Project Attributes

Field Description
Code Auto-generated identifier (e.g., RP-015)
Name Descriptive project name
Description Details about the project scope and objectives
Status Current project status
Owner User responsible for the project
Program Associated compliance program
Start Date When work begins
Target End Date Planned completion date
Actual End Date When the project was actually completed

Project Statuses

Status Description
Planning Project is being scoped and planned
Active Work is underway
On Hold Project is temporarily paused
Completed All tasks finished
Archived Project retained for historical reference

Creating a Project

  1. Navigate to Project Management
  2. Click New Project
  3. Fill in the project name, description, and assign an owner
  4. Optionally link the project to a compliance program
  5. Set target start and end dates

Projects can also be created automatically from audit findings, linking tasks directly to the audit items that generated them.

Tasks

Tasks represent individual corrective actions or work items within a project. Each task tracks its status, priority, assignee, and due date.

Task Attributes

Field Description
Task Number Auto-generated, scoped to the project (e.g., RP-015-001)
Title Brief description of the task
Description Detailed explanation of what needs to be done
Status Current task status
Priority Urgency level
Type Category of work
Owner User responsible for the task
Assignee User assigned to complete the task
Due Date Target completion date
Weakness Description For findings -- describes the identified deficiency

Task Statuses

Status Description
Open Task created, not yet started
In Progress Work is actively underway
On Hold Task is temporarily paused
Blocked Task cannot proceed due to a dependency or issue
In Review Work is complete and awaiting review
Completed Task is finished
Cancelled Task was cancelled
Risk Accepted Finding acknowledged but accepted without remediation

Task Priorities

Priority Description
Critical Requires immediate attention
High Should be addressed soon
Medium Standard priority
Low Can be addressed when convenient
Informational For tracking purposes only

Task Types

Tasks can be categorized as: Remediation, Enhancement, Maintenance, Risk Acceptance, Investigation, or Documentation.

Views

Summary View

The summary tab provides a high-level overview of the project, including:

  • Task statistics -- Total, open, completed, and overdue task counts
  • Progress bar -- Visual completion percentage
  • Project details -- Status, owner, program, and dates
  • Team members -- List of project members with their roles

Kanban Board

The board tab displays tasks as cards organized by status columns. Drag and drop tasks between columns to update their status.

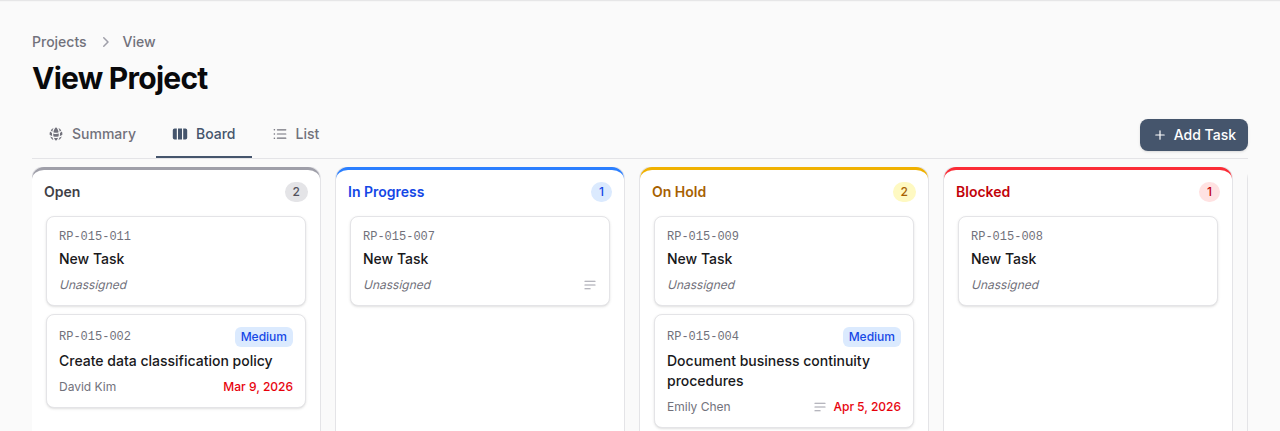

Kanban Board

Each task card shows:

  • Task number and title
  • Priority level (color-coded)
  • Assignee name
  • Due date (highlighted in red if overdue)
  • Subtask indicator

Task List

The list tab shows all tasks in a table format with sortable columns for task number, title, status, priority, assignee, and due date.

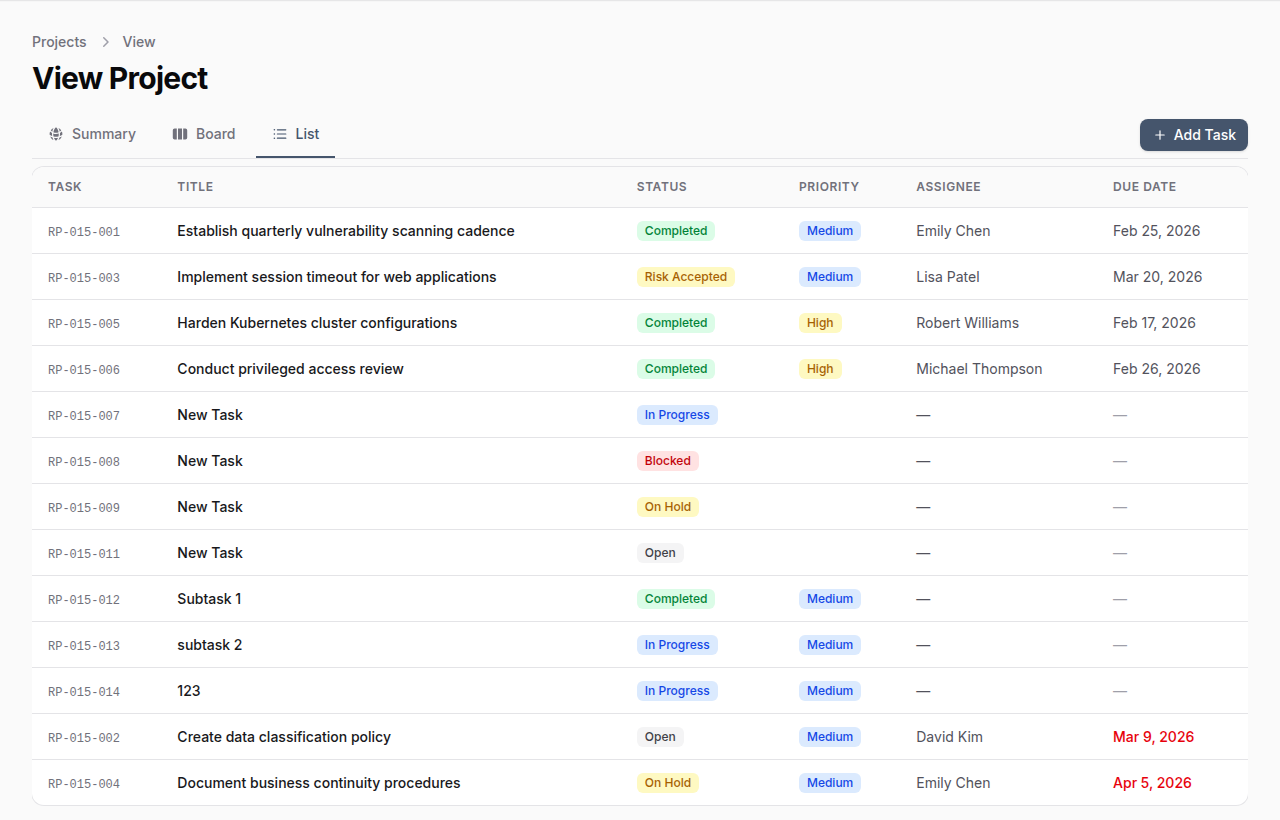

Task List

Creating Tasks from Audit Findings

One of the most powerful features of Project Management is the ability to create remediation tasks directly from audit findings. This maintains a traceable link between the original finding and the corrective action.

  1. Navigate to an Audit and open an audit item
  2. Click Create Remediation Task
  3. Select the target project, set a priority, and assign the task
  4. The task is created with the finding details pre-populated, including the weakness description from auditor notes

The source audit item remains linked to the task, providing full traceability from finding to remediation.

Notifications

Team members are automatically notified when:

  • They are assigned to a task
  • A task they own changes status
  • A project they are a member of has updates

Permissions

Access to projects is scoped by membership. Users can only see projects they own or are members of. Administrators have visibility into all projects.
